How to Choose a Solar EPC Contractor

Last reviewed August 2026 · written to be used against any contractor bidding, including us

A solar EPC contractor takes single point responsibility for engineering, procurement and construction of a solar plant, delivering it complete rather than supplying parts of it. The value of the model is that one party owns the outcome, so design errors, supply delays and installation defects are all their problem rather than yours to arbitrate between vendors. What determines whether that works in practice is how precisely the scope of work and its exclusions are defined.

The one line that matters most: in solar EPC, disputes almost never arise over the panels. They arise over the things nobody wrote down.

Why we publish this

Because a buyer who runs a proper evaluation gets a better project regardless of who wins it, and because we are content to be judged against these criteria. Take the checklist to every bidder.

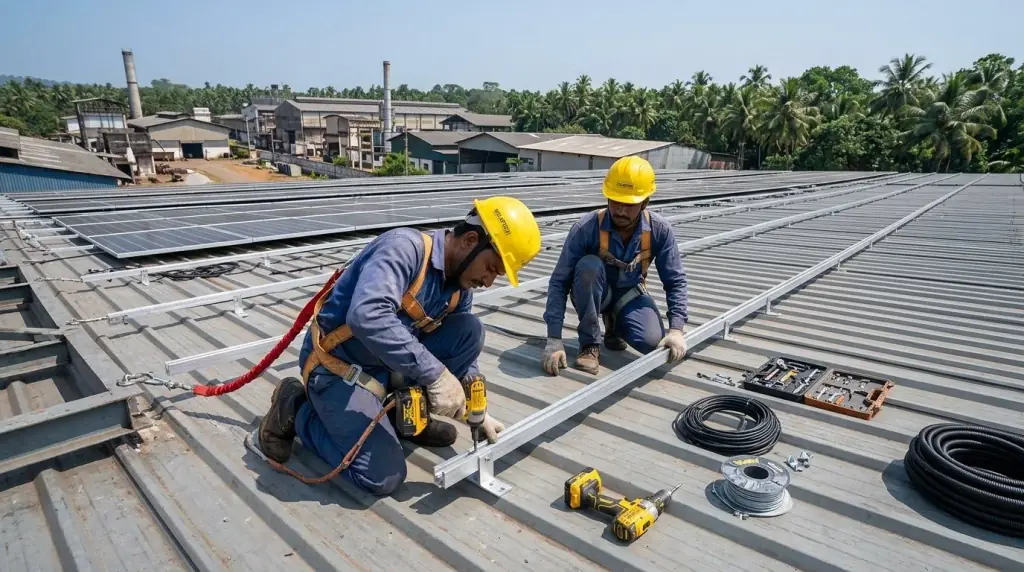

Installers bolting mounting rails to a factory sheet roof beside a partly completed row of solar modules

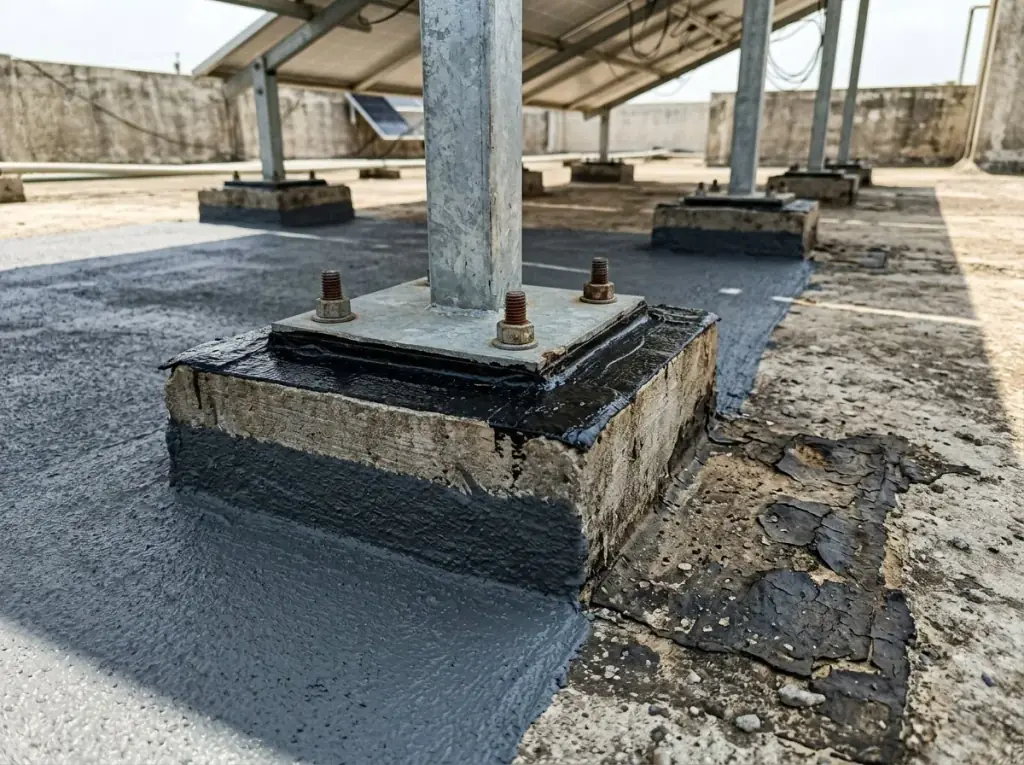

Base plate bolted to a concrete plinth with fresh waterproofing dressed around the penetration, beside an older weathered patch
Sealing the penetrations we create is our scope. Renewing waterproofing that was already near the end of its life is not, and that distinction belongs in the contract.
Mid-build, which is where an EPC contract is either working or quietly failing. A finished array tells you nothing about how it was delivered.

The three letters

What EPC commits the contractor to

EPC stands for engineering, procurement and construction, and it describes a delivery model rather than a type of company. Under an EPC contract a single party designs the plant, buys the equipment and builds it, handing over a working installation. The defining characteristic is single point responsibility: when something does not work, there is one party accountable rather than a design consultant, a supplier and an installer pointing at each other.

E

Engineering

Electrical design including string configuration, cable sizing and protection coordination. Structural design of the mounting system and its foundations or fixings. Layout, shading analysis and generation modelling. Where required, design certification by a qualified engineer.

P

Procurement

Sourcing modules, inverters, structures, cables, protection equipment and balance of system, to the specification in the contract. This is where compliance obligations such as ALMM listing and DCR status sit.

C

Construction

Site preparation and civil works, structural erection, module installation, electrical works, earthing, testing and commissioning.

Why single point responsibility is worth paying for

On a split contract, a system underperforming raises an immediate question: is it the design, the equipment or the installation? Each party has an interest in the answer being one of the others.

Under EPC that question is not yours to resolve, which is the entire commercial point of the model.

Where it breaks down

Single point responsibility only extends as far as the scope. Anything excluded from the contract is outside it, and if a project needs something nobody scoped, the gap falls to you regardless of what the cover page says about turnkey delivery.

The scope boundary is the most consequential thing on this page.

Delivery models

EPC, or something else

EPC is one of several ways to buy a solar plant, and it is not automatically the right one. Supply-and-install contracting, EPCM arrangements and item rate contracts each suit different buyers, depending on how much technical capability sits in-house and how much risk the buyer wants to hold rather than pay someone else to carry.

Model matcher

Three questions about you, not the plant

Do you have in-house electrical and structural engineering?
What do you need from the price?
Will you coordinate several contractors yourself?

Likely fit

EPC, turnkey lump sum

Without in-house electrical and structural engineering, or with a budget that has to hold, single point responsibility is worth what it costs. One party owns the outcome and the price includes their allowance for the risks they carry.

Then spend your effort on the scope boundary rather than on the price, because that is where an EPC contract succeeds or fails.

Go to the scope boundary →
ModelWho holds the risk
EPC, turnkey lump sumThe contractor, within the defined scope
Supply and installSplit. Supplier for equipment, installer for workmanship
EPCMYou, with the contractor managing on your behalf
Item rateLargely you, since quantities are measured
RESCO or OPEXThe developer, who owns the asset

What you pay for under EPC

A lump sum EPC price includes the contractor’s allowance for the risks they are carrying: quantity variation, price movement in equipment, weather, and the cost of putting right anything within their scope.

That allowance is real and it is priced in. A buyer able to carry some of it themselves can sometimes buy the same plant for less under a different model, which is a legitimate choice rather than a failure of EPC. CAPEX vs OPEX vs RESCO covers the funding side.

The scope boundary

Who does what, and the eight gaps that cause disputes

Most disputes on solar EPC projects arise not from the equipment but from work that neither party scoped. A contract that lists the panels and inverters in detail while leaving roof waterproofing, construction power, crane access, approvals liaison or the high tension interface undefined has left the expensive questions unanswered. The scope boundary should be agreed line by line before signing, with exclusions stated as explicitly as inclusions.

the eight gaps, all in this quadrant12345678910111213how easily it is left unstated →cost to resolve later →Scope items, positioned by judgement rather than survey data1  Roof waterproofing renewal2  HT interface and transformer3  Roof strengthening4  Construction power and water5  Existing switchgear interface6  Approvals liaison7  Inverter room civil works8  Geotechnical investigation9  Crane and access10 Erection insurance11 Earthing12 Cabling13 is commissioning. Our own view from projects, offered as a prompt for your tender rather than as research.

Scope checklist

Mark each line contractor, client or excluded. Leave nothing blank.

0 of 28 marked0 of 8 high-risk
Site survey and shading studyusually ContractorLow gap risk
Geotechnical investigation, ground mountusually VariesHIGH gap risk
Electrical design and drawingsusually ContractorLow gap risk
Structural design and certificationusually ContractorMedium gap risk
Structural strengthening of existing roofusually Usually excludedHIGH gap risk
Roof waterproofing repair or renewalusually Usually excludedHIGH gap risk
Waterproofing at penetrationsusually ContractorMedium gap risk
Module, inverter and structure supplyusually ContractorLow gap risk
DC and AC cablingusually ContractorLow gap risk
Cable trenching and civil, ground mountusually ContractorMedium gap risk
Earthing and lightning protectionusually ContractorLow gap risk
Inverter room or enclosure civil worksusually VariesHIGH gap risk
Transformer and HT interfaceusually Often excludedHIGH gap risk
Metering panel and interface with existing switchgearusually VariesHIGH gap risk
Utility application, liaison and follow-upusually VariesHIGH gap risk
Subsidy application and follow-throughusually VariesMedium gap risk
Sanctioned load enhancement or phase conversionusually VariesMedium gap risk
Crane, hoist and access equipmentusually ContractorMedium gap risk
Scaffolding and edge protectionusually ContractorLow gap risk
Construction power and waterusually Usually clientHIGH gap risk
Material storage and site security during worksusually VariesMedium gap risk
Erection all risk insurance during constructionusually VariesMedium gap risk
Testing and commissioningusually ContractorLow gap risk
As-built drawings and documentationusually ContractorMedium gap risk
Operator trainingusually VariesLow gap risk
Monitoring configurationusually ContractorLow gap risk
Module cleaning during defect liabilityusually VariesMedium gap risk
Sparesusually Usually excludedLow gap risk

Nothing marked yet

Take this into the tender or the quotation conversation and require every line to be marked. A contractor who will not commit each item to a column is telling you something useful.

On roof waterproofing specifically

It is the most common and most bitter dispute. An array is designed to sit on the roof for twenty-five years. If the waterproofing beneath it is near the end of its life, it should be renewed before installation, and that is almost always outside an EPC scope.

Establish the roof’s condition and who is paying to remedy it before the contract is signed, not when a leak appears in the second monsoon and both parties reach for the paperwork.

What to do with this checklist

Take it into the tender or the quotation conversation and require every line to be marked. The eight high-risk lines are the ones to settle first. A contractor who marks the exclusions honestly and prices them separately is easier to deal with than one who leaves them ambiguous and raises them later.

Commercial terms

What the contract should say

Beyond scope, a solar EPC contract needs to define the payment structure, the programme and what happens if it slips, the performance the plant must achieve and what happens if it does not, the period during which the contractor must return to fix defects, and how variations and disputes are handled. Each of these is standard in construction contracting and each is frequently thin or absent in solar quotations.

AdvanceEquipmentErectionElectricalCommissioningRetention releasedagainst a bankguaranteedelivered to sitestructure completecabling, inverters,earthingrecorded test resultsend of defect liability periodyour only leverage on defects sits in this gapMilestone structure, tied to delivered progress rather than to the calendarSequence shown, proportions deliberately not. The split between milestones is a commercial negotiation.

Payment structure

Milestone-based, tied to delivered progress. Two protections worth insisting on:

An advance bank guarantee covering any mobilisation advance, so the money is recoverable if the contractor does not perform.

Retention held until the end of the defect liability period, or a performance bank guarantee in its place. Paying the final instalment at commissioning removes your only leverage on defects.

Programme and delay damages

A dated programme with key milestones, and liquidated damages for delay expressed as a rate per week with a cap.

Delays outside the contractor’s control, chiefly utility approvals, should be carved out explicitly, because holding a contractor to a date that depends on a third party is neither fair nor enforceable.

Defect liability period

The period after commissioning during which the contractor returns and rectifies defects at their own cost. Establish its length, what it covers, response times, and whether it includes module cleaning and routine maintenance.

A defect liability period is not the same thing as an operations and maintenance contract, and buyers frequently conflate them.

Variations and change orders

How additional work is instructed, priced and approved. Without a mechanism, every unforeseen item becomes a negotiation at the point of maximum leverage for whichever party is holding up the work.

Add insurance, statutory and safety compliance, and dispute resolution. The last is worth a paragraph even on a small contract, because its absence is only noticed when it is needed.

Four warranties, three durations, one common confusion

A quotation saying “25 year warranty” is telling you very little. These are separate obligations from separate parties.

Module productModule performanceInverterContractor workmanshipmanufacturer, typically around a decadeagainst manufacturing defectsmanufacturer, out to around 25 to 30 yearsa declining output floor, not a promise of outputmanufacturer, commonly 5 to 10 years, extendablewhatever the contract says, and the one you negotiateIndicative market shape, not a commitment from us. Ask for the four separately, and ask who pays the labour on a claim.

Performance guarantees

Performance ratio, and how to make the guarantee mean something

A solar plant’s performance is usually guaranteed through a performance ratio, which expresses actual generation as a proportion of what the installed capacity should have produced given the solar radiation actually received. Because it normalises for weather, a performance ratio guarantee is meaningful in a way a promise of annual units is not, since the latter can be missed for reasons that have nothing to do with the plant.

Guarantee tester

Tick what the offered guarantee actually contains

Decoration

0 of 5

A performance guarantee without a stated value, a measurement method or a remedy is a sentence in a proposal, not an obligation.

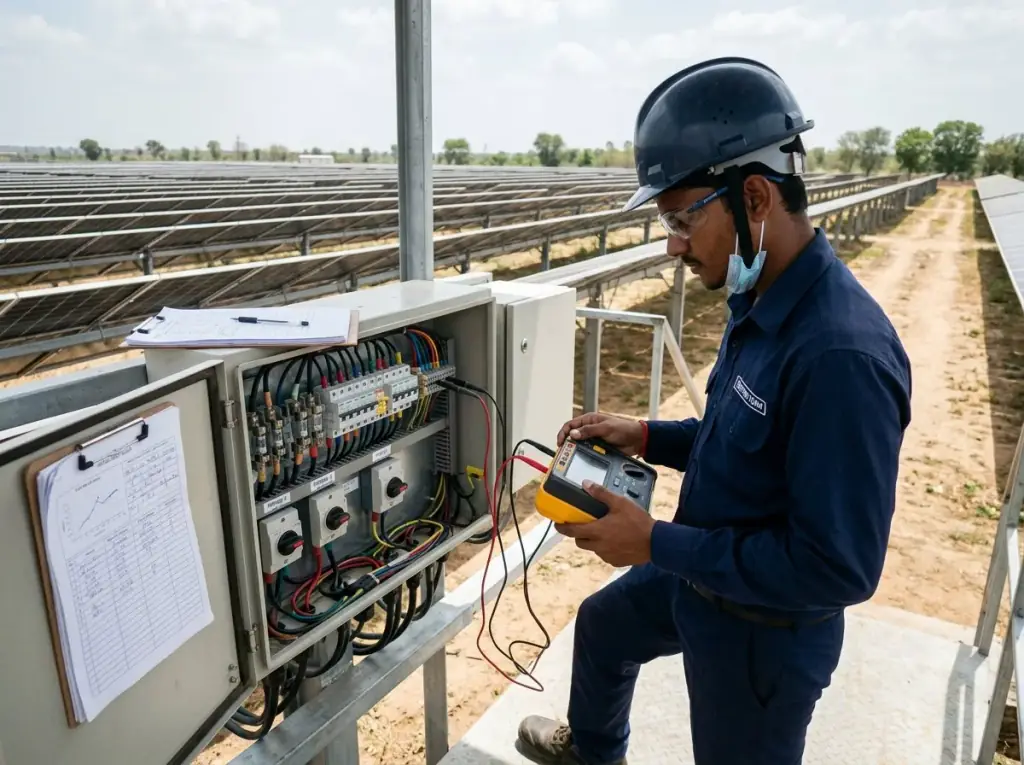

Technician testing insulation resistance at an open string combiner box with recorded results on a clipboard
String-level testing at commissioning is how an underperforming string gets found in week one rather than year three.

The practical alternative on smaller projects

On a residential or small commercial system a full performance ratio regime is disproportionate. What works instead is a stated expected monthly generation figure, set at handover and accounting for seasonal variation, with monitoring configured so the owner can compare against it.

That is a benchmark rather than a contractual guarantee, and for a small system it is usually the more useful thing.

Ask what happens at commissioning

Insulation resistance testing, string-level open circuit voltage and operating current verification, earth continuity, and the results recorded rather than confirmed verbally. The absence of string-level testing from a commissioning scope is a genuine warning sign.

Evaluation

What to ask everyone bidding, including us

Solar EPC contractors differ far more than their quotations suggest, and the differences that matter are rarely visible in a headline price. What distinguishes them is who carries out the work, what is specified where it cannot be seen, how completely the scope is defined, and whether they will still exist to honour a workmanship warranty in year seven.

Answered so far

0 of 10

A contractor unwilling to answer any of the ten is answering it anyway.

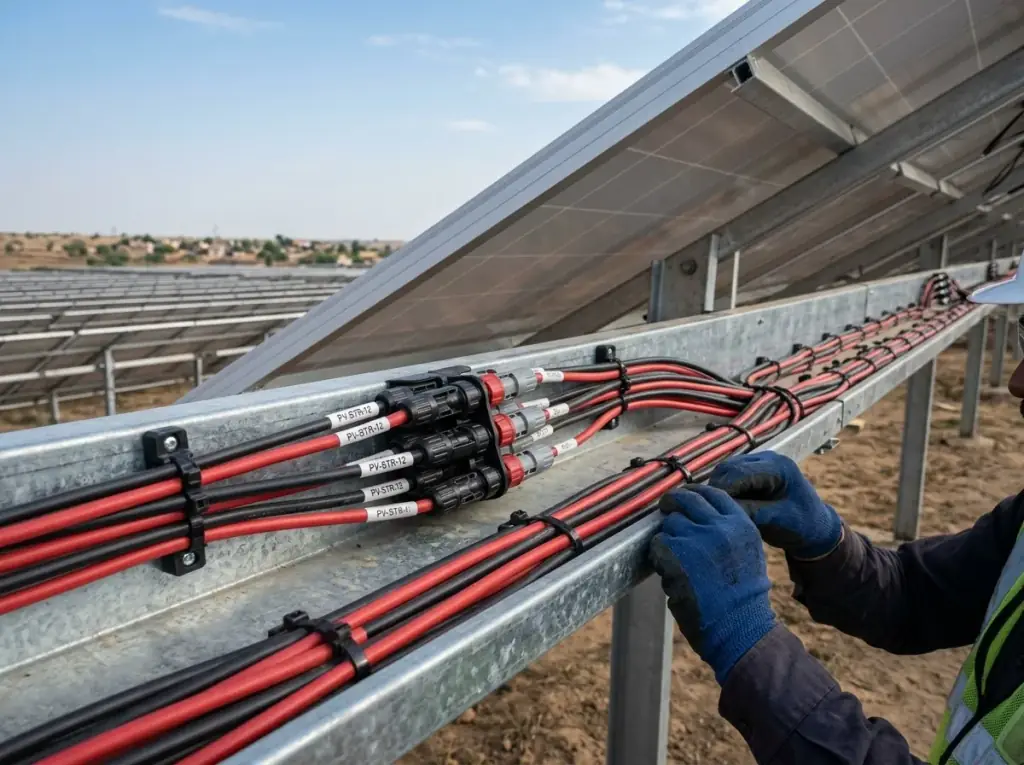

Solar DC cables bundled and clipped along a galvanised cable tray with labelled connectors
Question three, made visible. Nothing here appears on a quotation total, and all of it decides how the system ages.

Our position on this list

We publish it because we are content to be evaluated against it, and because a buyer who asks these questions of every bidder gets a better project regardless of who wins.

Turnkey

The word does less work than people think

Turnkey describes a contract under which the contractor delivers a complete working installation, and it is frequently used to imply that everything is covered. What it actually means is that everything within the defined scope is covered. Turnkey delivery of a scope with significant exclusions is still turnkey, and the exclusions are where the cost lands.

Commonly outside a turnkey solar scope, unless specifically included

Roof strengtheningWaterproofing renewalHT interface and transformerExisting switchgear modificationsConstruction power and waterStatutory and local body approvalsLand use permissionsSite levelling and access roadsLoad enhancement chargesCleaning after defect liabilitySpares

None of these are unreasonable exclusions. Several are genuinely outside a solar contractor’s competence, and some depend on decisions only you can make. The problem is not that they are excluded, it is that they are frequently not mentioned until they are needed.

The fix costs nothing

Require the contract to contain an explicit exclusions list, not just an inclusions list.

A scope that says what is not included is worth more than one that says only what is, and a contractor who writes that list unprompted is one who has done this before.

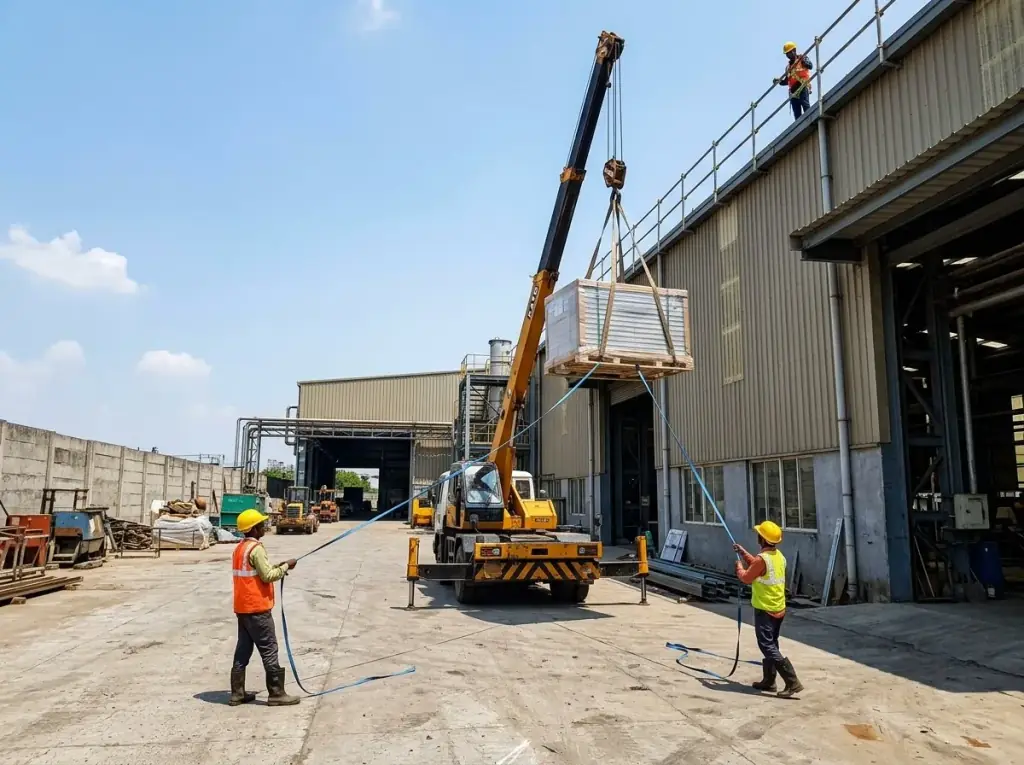

Mobile crane lifting a pallet of solar modules to a factory roof with workers steadying tag lines
Access equipment is usually contractor scope. Usually is not a contract term.

Where we fit

How Blues Renewables works

Blues Renewables delivers solar EPC across Tamil Nadu, covering rooftop and ground mounted installations for residential, commercial, institutional and industrial clients. We install with our own team rather than subcontracting, which means the person who surveyed the site is accountable for what happens on it, and we itemise scope and exclusions rather than presenting a lump sum and raising gaps later.

How we contract

  • +Itemised quotation naming every component, brand and specification, so it can be compared line by line
  • +Scope and exclusions stated explicitly, using the checklist above
  • +Our own installation team, not subcontracted crews
  • +Approvals handled, including utility application, net metering and subsidy filing, followed through to disbursal
  • +Recorded commissioning with test results, string-level verification and a documentation handover
  • +Two years of maintenance included from commissioning, with an AMC available afterwards

What we exclude, stated here rather than in the small print

  • –Roof strengthening and waterproofing renewal where a roof needs work before an array can go on it
  • –High tension interface and transformer works on larger installations
  • –Statutory approvals beyond the utility application
  • –Land use permissions on ground mount projects

Where any of these apply we tell you at the survey and price them separately, or point you to who should do them.

As-built electrical drawings and a bound test report folder being handed over across a table
The handover pack. It is the difference between owning a system and owning a mystery.

Put us through it

Get an itemised proposal

Send us twelve months of electricity bills and tell us about the site. We will survey properly, model the load, and come back with an itemised proposal setting out scope, exclusions, specification and price line by line. Compare it against anyone else using the checklist on this page. That is what it is for.

Handing a prospect the checklist and then filling it in completely, in front of them, does more than any claim about quality. That is the whole idea.

Scope and exclusions included

Request an itemised proposal

We respond within one working day. Your details stay with us and are never sold.

Solar EPC contracting, answered

What is a solar EPC contractor?

A contractor who takes single point responsibility for engineering, procurement and construction of a solar plant, delivering it complete rather than supplying parts of it. The value of the model is that one party owns the outcome, so design errors, supply delays and installation defects are theirs to resolve rather than yours to arbitrate between vendors.

What does EPC scope of work include?

Electrical and structural design, equipment procurement, civil and structural works, module and electrical installation, earthing, testing and commissioning. What varies between contracts, and where disputes originate, is the treatment of items such as roof strengthening, waterproofing renewal, the high tension interface, construction power, approvals liaison and access equipment. Each should be marked explicitly as included, client scope or excluded — the checklist above is built for exactly that.

What is the difference between EPC and supply and install?

Under EPC one party holds responsibility for the whole outcome within the defined scope. Under supply and install the responsibility is split, with a supplier accountable for equipment and an installer for workmanship, which leaves the buyer to determine which is at fault when something underperforms. EPC costs more because the contractor prices the risk they are carrying.

What causes most solar EPC disputes?

Scope gaps rather than equipment. Roof waterproofing, roof strengthening, the high tension interface, construction power and water, approvals liaison and modifications to existing switchgear are the items most commonly left unstated, and each is expensive enough to matter when it surfaces mid-project.

What is a performance ratio guarantee?

A guarantee expressing actual generation as a proportion of what the installed capacity should have produced given the solar radiation actually received. Because it normalises for weather it is more meaningful than a promise of annual units. To be enforceable it needs a stated value, a defined measurement method and period, an explicit exclusions list, and a remedy if it is not met.

Should I hold retention on a solar EPC contract?

Yes, or take a performance bank guarantee instead. Paying the final instalment at commissioning removes your only practical leverage if defects appear during the defect liability period. Retention is standard construction practice and a reasonable contractor will expect it.

Is a defect liability period the same as a maintenance contract?

No, and they are frequently conflated. A defect liability period obliges the contractor to return and rectify defects at their own cost for a defined period after commissioning. Maintenance covers routine activity such as cleaning, inspection and monitoring. Establish which is included, for how long, and what falls outside both.

What does turnkey actually mean?

That the contractor delivers a complete working installation within the defined scope. It does not mean everything is covered. Turnkey delivery of a scope with significant exclusions is still turnkey, which is why an explicit exclusions list is worth more than an inclusions list alone.

How do I compare two EPC quotations?

Not on the total. Compare the specification of what cannot be seen, meaning structure material and coating, fastener specification, cable sizing, protection devices and earthing, since that is where price differences usually hide. Then compare the scope line by line, the four warranty periods separately, and the commissioning scope.

Should I appoint an EPC contractor or manage it myself?

EPC suits buyers without in-house electrical and structural engineering capability, who want a fixed price and one accountable party. A split contract can work for an organisation with a competent projects or maintenance engineering function, a straightforward site and the appetite to manage interfaces. The EPC price includes the contractor’s allowance for the risk they carry, which is real and is priced in.

Call nowGet a proposal
